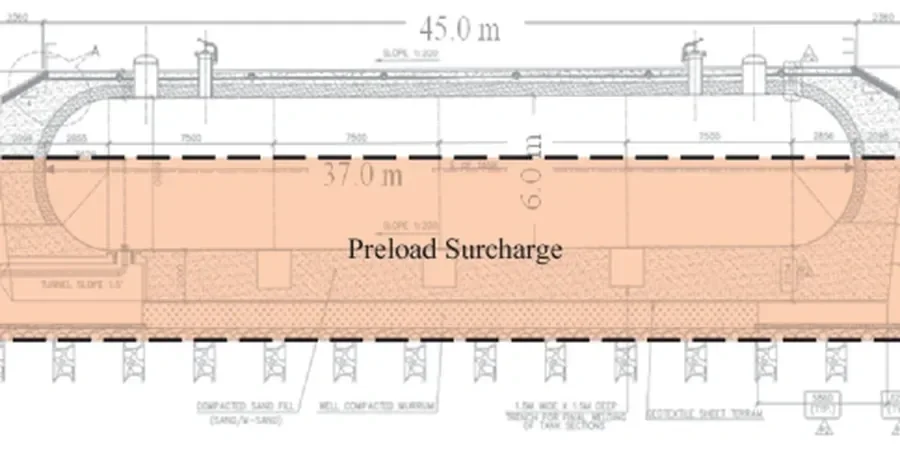

Sites along the Catawba River floodplain in Charlotte often have deep alluvial clays with natural water contents above 40%, while areas near Uptown sit on residual saprolite from granite gneiss. A preloading design without surcharge in Charlotte must account for this contrast: the Piedmont residual soils drain faster but the floodplain clays require staged fills with monitored pore pressure dissipation. We typically cross-check consolidation parameters from oedometer tests against field data from a presurometer test to refine the time-rate predictions. For projects in the South End redevelopment zone, this approach has cut wait times by nearly 30% compared to empirical estimates.

Kaolinitic clays in Charlotte show secondary compression ratios above 0.005 under sustained fill — 30% higher than typical Piedmont residual soils.
Scope of work
Area-specific notes
Our monitoring crew sets up pneumatic piezometers and settlement plates at 15-meter intervals across the fill area. In Charlotte we see the biggest risk not from undrained failure but from differential movement between the floodplain clay and the adjacent residual soil zones — a transition that can happen within 20 meters horizontally. The settlement plates measure to 0.1 mm accuracy and we log pore pressures daily during the first month. If the excess pore pressure ratio exceeds 0.6, we pause the next lift and extend the waiting period. This real-time control prevents the shear failure that would require removing fill and starting over.
Standards used
ASTM D2435 (Standard Test Methods for One-Dimensional Consolidation), ASTM D1586-18 (Standard Test Method for Standard Penetration Test), ASCE 7-22 (Minimum Design Loads and Associated Criteria for Buildings), FHWA NHI-16-072 (Ground Modification Methods, Chapter 5: Preloading)
Linked services
Consolidation Testing & Parameter Interpretation
Incremental loading consolidation tests (ASTM D2435) on undisturbed tube samples from the site. We report Cc, Cr, cv, and preconsolidation pressure (σ'p) for each soil layer, then input these into staged fill simulations using a 1-D finite difference model.
Staged Fill Design & Instrumentation Planning
Design of the fill height, lift thickness, and waiting periods based on the target post-construction settlement (typically 25–50 mm). We specify the piezometer and settlement plate layout, plus trigger criteria for pausing lifts.
Settlement Monitoring & As-Built Verification
Installation and daily reading of pneumatic piezometers and settlement plates during the preloading period. We compare field data against the predicted consolidation curve and issue weekly progress reports with revised time-to-completion estimates.
Typical parameters
Top questions
How does preloading without surcharge differ from preloading with surcharge in Charlotte soils?
Preloading without surcharge uses fill heights equal to the final design load, while surcharge uses additional temporary fill to accelerate consolidation. In Charlotte's floodplain clays, preloading without surcharge typically requires 180–300 days to reach 90% consolidation for a 5-meter clay layer, compared to 90–150 days with surcharge. The trade-off is no extra fill handling and less risk of bearing failure during placement.
What settlement magnitude can I expect after preloading without surcharge on a Charlotte site?
Based on our work on sites near the I-485 corridor, primary consolidation settlements typically range from 150 mm to 400 mm for fill heights of 2.5 to 4.5 meters on clay layers 4 to 8 meters thick. Secondary compression (creep) adds another 20–50 mm over the first year after construction. We verify these values with field monitoring during the preloading period.
How much does a preloading design without surcharge cost in Charlotte?
A complete preloading design without surcharge package, including field investigation, consolidation testing, staged fill design, and instrumentation plan, typically ranges from US$640 to US$2,040 depending on the number of soil borings and the depth of the compressible layer. Monitoring during the preloading period is quoted separately based on duration and instrument density.
When is preloading without surcharge not recommended in Charlotte?
This method is less effective when the compressible layer exceeds 10 meters in thickness unless combined with vertical drains. It also performs poorly on organic soils or peats with natural water contents above 100%, which are rare in Charlotte but occur in isolated pockets along the Catawba floodplain. In those cases, we recommend surcharge preloading or Improvement alternatives like deep soil mixing.
